Forensic Case Study on Construction Communication Failures
Pages
11
Time to read
22 mins
Publication
Language
English
Pages
11
Time to read
22 mins
Publication
Language
English

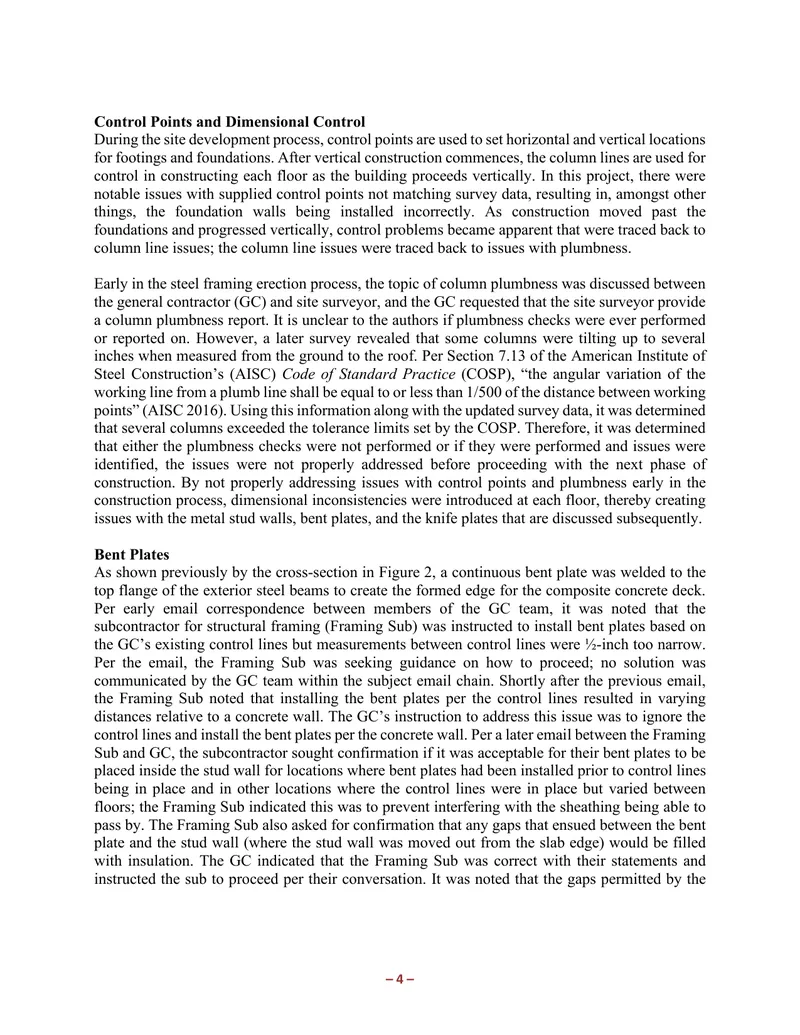

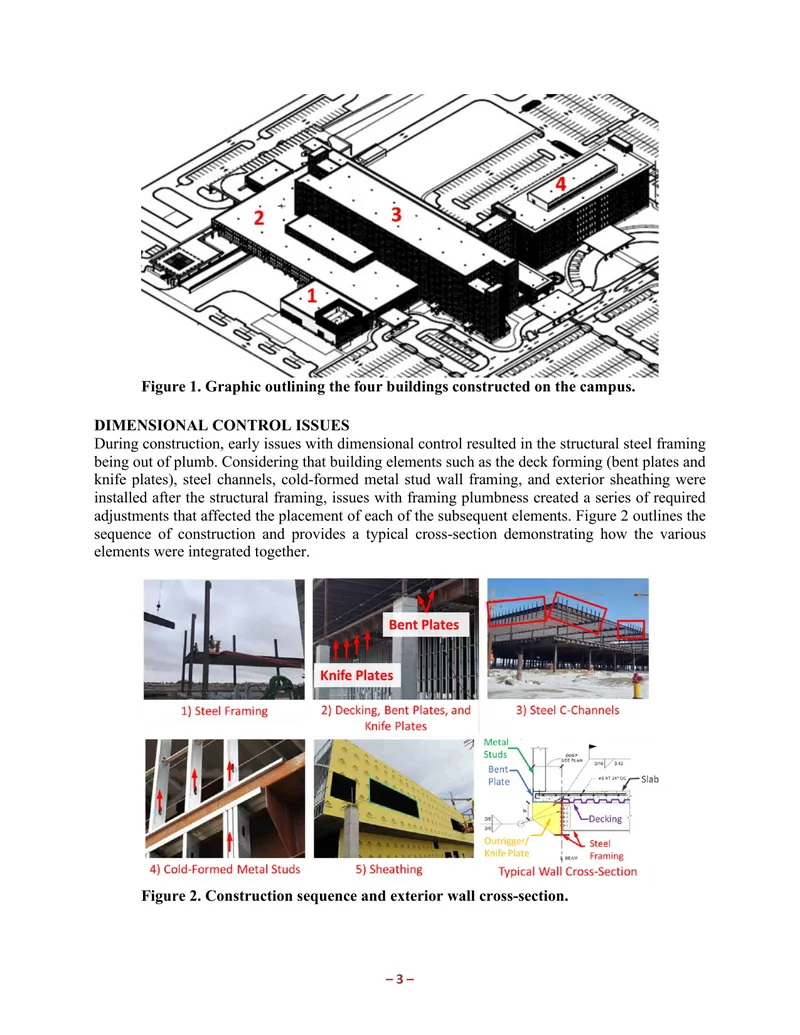

This technical report presents a forensic case study that investigates the breakdowns in communication, coordination, and collaboration during a construction project, which led to significant delays and defects. The report outlines how improper communication and coordination resulted in dimensional control issues, particularly affecting the steel erection phase of the project. It describes the cascading effects of these issues, including the need for adjustments in construction methods and the installation of structural components by multiple subcontractors. The authors detail specific incidents, such as an explosion caused by a propane heating setup, which halted construction. The findings emphasize the role of project management in these failures and discuss how better adherence to the principles of effective communication, coordination, and collaboration could have mitigated the problems encountered. The report also references industry standards and definitions related to these critical aspects of project management, providing a comprehensive analysis of the factors contributing to the project's shortcomings.
