Calculating the As-Built Critical Path Procedures
Pages
24
Time to read
26 mins
Publication
Language
English

Pages
24
Time to read
26 mins
Publication
Language
English

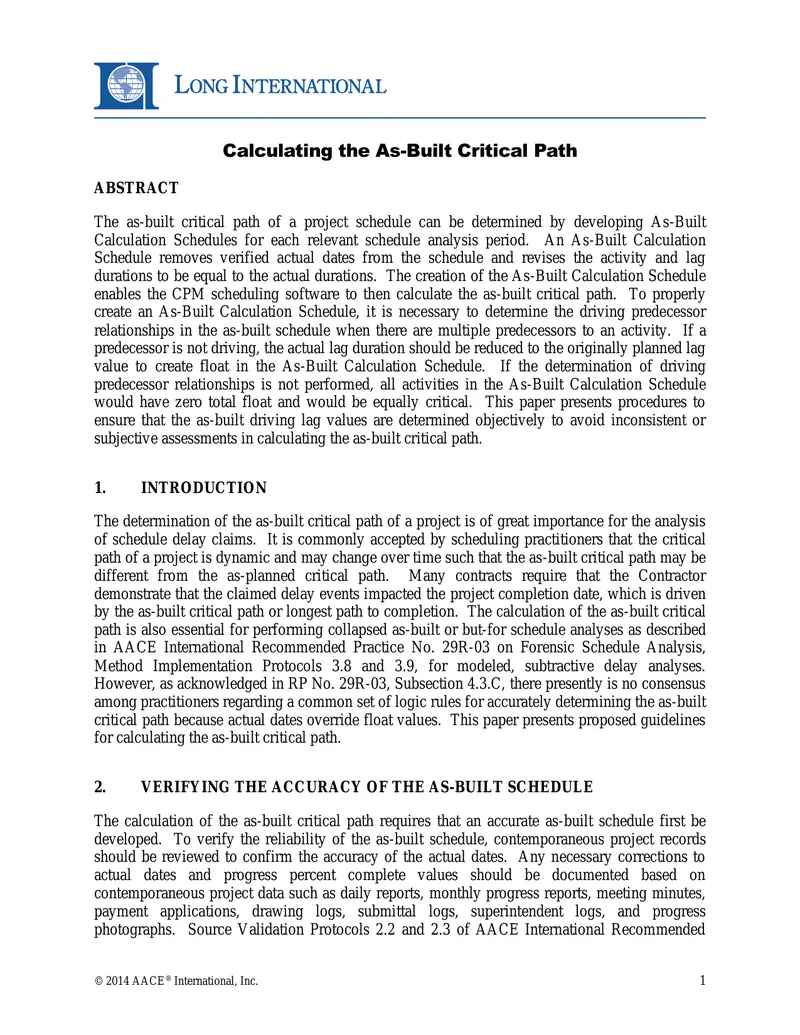

This guide by Andrew Avalon, P.E., PSP, provides a comprehensive approach to calculating the as-built critical path in project scheduling. It covers verifying schedule accuracy, converting as-planned logic to as-built logic, and creating calculation schedules. The document includes detailed procedures, tables, and figures to assist practitioners in accurately determining critical paths, essential for analyzing schedule delays and claims. Published by AACE International, this resource is vital fo
