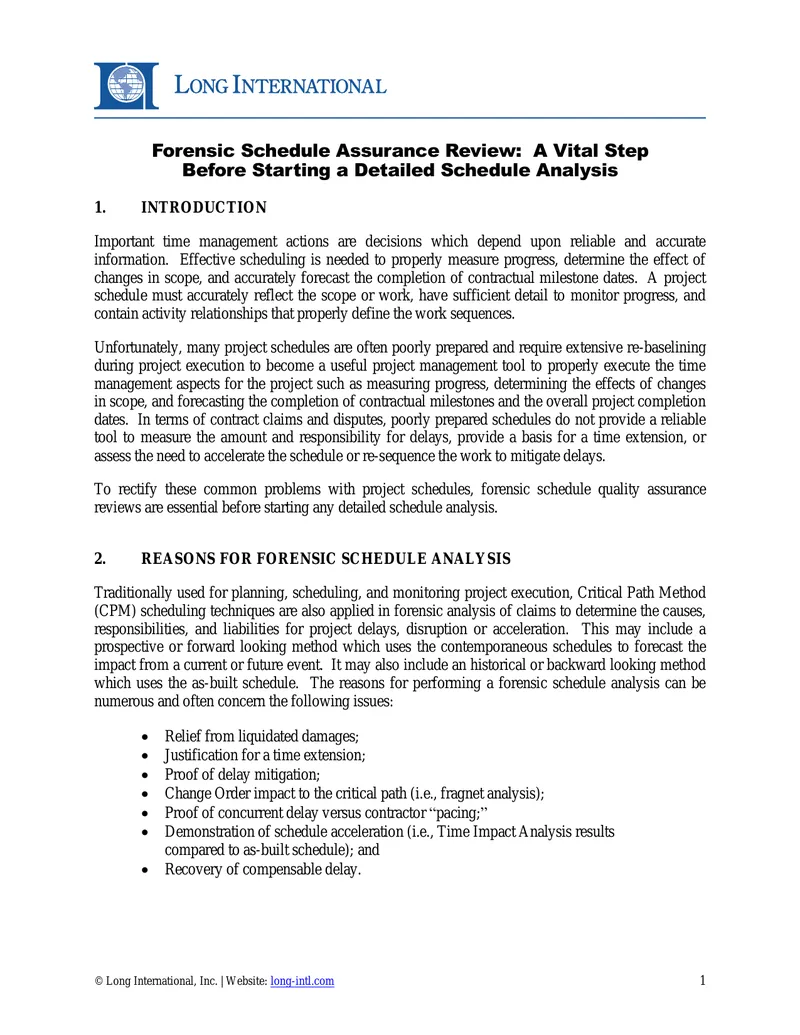

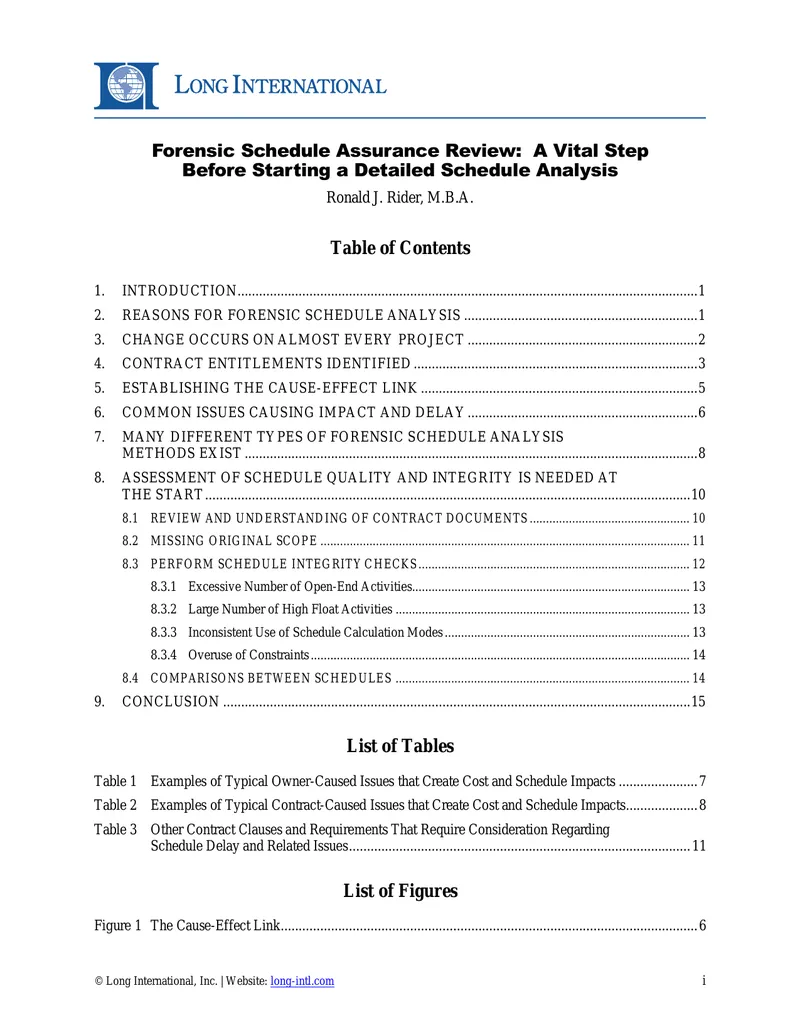

Long International
Forensic Schedule Assurance Review Process
Pages
17
Time to read
30 mins
Publication
Language
English
Pages
17
Time to read
30 mins
Publication
Language
English

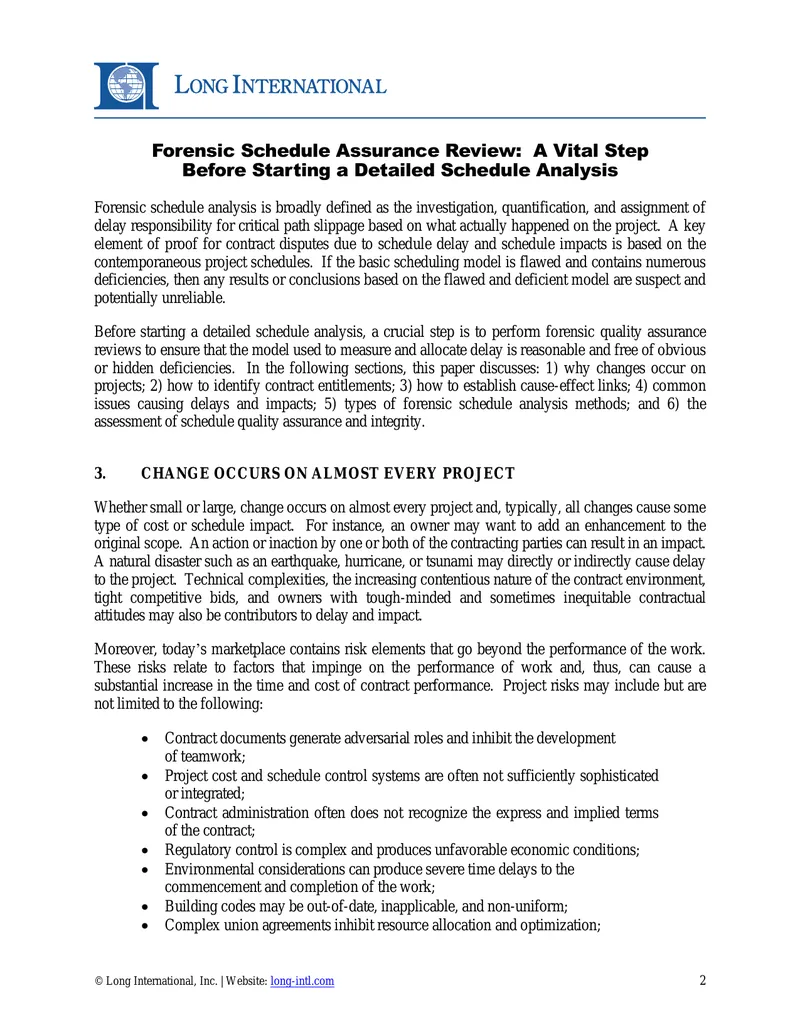

This document is a technical report that outlines the importance of conducting forensic schedule assurance reviews before initiating detailed schedule analyses in project management. It emphasizes that effective scheduling is crucial for accurately measuring progress, assessing the impact of changes, and forecasting completion dates. The report details common issues associated with poorly prepared project schedules, which can lead to unreliable assessments of delays and contractual disputes. It presents various reasons for forensic schedule analysis, including the need for relief from liquidated damages, justification for time extensions, and proof of delay mitigation. The report also discusses the significance of understanding contract entitlements and the various types of claims recognized in construction disputes. Furthermore, it highlights the necessity of ensuring that the scheduling model is free from deficiencies to provide reliable results in delay analysis. The document serves as a guide for professionals involved in project scheduling and management.
